#PM Time Management—What are Your Options to Shorten a Schedule?


One of the problems that a project manager can be faced is when the project duration is estimated to be X number of months, but you are told by management that it must be done according to a shorter schedule, i.e., X minus some number of months. What are your options?

Well, the basic iron law of constraints says that if one constraint, in this case, time, is affected, then this will affect the other constraints. Some techniques for shortening the schedule affect one constraint, while others affect other constraints. Sometimes you are faced with a situation question on the PMP exam that gives you information about the project, says that the scheduled must be shortened somehow, and asks you how would do it. The answer depends on what changes in the other constraints can be most easily accommodated by the project, and this in turn depends on the information given about the project.

1. Options to Shorten a Schedule

Option

Disadvantage

Advantage

Explanation

1. Crashing ↑ costs No ↑ risk Crashing involves adding extra resources to get the same activity done in less time with no appreciate rise in risk.
2. Fast-tracking ↑ risk No ↑ costs This takes activities which are sequential and makes them concurrent; increases risk.
3. Reestimating ↑ PM management time to do reestimate ↓ risk Reviewing risk assumptions inherent in time/cost estimates is a way to reduce risk and therefore reduce time estimates.
4. Scope reduction ↓ customer satisfaction No ↑ costs, risk, time You can reduce the scope as a last resort, but customer may balk at reduced scope.
5. Quality reduction ↓ customer satisfaction No ↑ costs, risk, time You can reduce the quality level to save time/money, but customer may not be satisfied.

There are two options which are NOT recommended by PMBOK® Guide or the PMP exam prep text by Rita Mulcahy. These are a) stand your ground and insist on the original schedule, because you do not have authority to do so as a project manager vis-à-vis the sponsor; b) work overtime. Working overtime in an emergency is one thing, but working overtime on a regular basis on a project is a symptom of poor planning.

2. Example

If the question talks about few resources on a project, then fast-tracking may be the best bet. For fast-tracking, one more requirement is that the activities have a preferential dependency, meaning that they CAN be made concurrent (with higher risk). If the dependency between activities is mandatory, and therefore they MUST be sequential, then fast-tracking is not an option because they CANNOT be made concurrent.

If the question talks about abundant resources and low risk, then crashing is okay.

If the question talks about high risk on a project, then reestimating is a good choice because this will involve lowering risk.

If the questions talks about how there are fewer resources (and so crashing is not feasible) and the activities cannot be made concurrent (and so fast-tracking is not feasible), then you may have to consider reducing scope and/or quality on a project.

3. Summary

The purpose of this post is to give you confidence in answering situational questions about a compressed schedule.

#PM Time Management—What makes the Critical Path so Critical?


1. Introduction—Critical Path method’s place in the processes

Once the network diagram connecting the activities has been created in the process 6.2 Sequence Activities, and the processes 6.3 Estimate Activity Resources and 6.4 Estimate Activity Durations have been completed, it is time to go to the final planning process in the Time Management Area, 6.5 Develop Schedule.

The key to finding out the accurate estimate of the entire project is the critical path method. The purpose of this post is not to outline this method, but to discuss a little why it is so critical. Of course the length of the project depends on it, which you would think makes it critical enough.

But if studying the PMBOK® Guide has taught me anything, it is that project management is like an ecology, albeit one with processes rather than organisms. What happens in one process will affect all of the others. Knowing the critical path is crucial to managing other knowledge areas as well. That is what I will discuss today.

2. Critical Path and its effect on other knowledge areas

The critical path is the path of activities that has the longest total duration, which gives the shortest possible time the project could be completed within. This statement seems contradictory to some in our study group at first, but it really isn’t. The important point is that any delay on the critical path WILL delay the end date of the project. A delay on a non-critical path will not delay the project until the delay becomes longer than the activity’s float.

Finding out the critical path is important, but finding out those near-critical paths and non-critical paths are important as well. Near-critical paths are those that are very close in duration to the critical path. If the critical path is compressed, this near-critical path may then become by default the new critical path. Non-critical paths are useful for a project because they contain float, which is described above as the amount of time an activity can be delayed before it affects the overall project schedule. By definition, activities on the critical path have zero float because any delay in those activities will affect the overall project schedule.

Project Management Area What effect does knowing Critical Path have?
1. Integration Management When it comes to integrated change control, a critical question for evaluating the change is the effect that that change will have on the project schedule, which can be seen through its changes on activities on the critical path.
2. Scope Management If the scope is to be changed, then its effect on the other two major constraints, time and cost, must be analyzed. The critical path will show if additional activities to account for the additional scope will delay the project.
3. Time Management If you want to compress the project schedule, then the critical path gives you the options of which activities to crash.
4. Cost Management Crashing is where you add resources to an activity to reduce the time it takes to complete it. Conversely, if you need resources somewhere else in the organization, you can remove resources from an activity and delay its completion as long as that activity is not on the critical path.
5. Quality Management If it is necessary to shorten the schedule, then seeing how quality management may reduce time-consuming rework, etc., may assist if those activities are on the critical path.
6. HR Management Those human resources that are less experienced can be put on activities not on the critical path, with the experienced people being reserved for activities on the critical path.
7. Communications Management If you are asked by management, “Why will the project take so much time”, you can answer the question.
8. Risk Management Activities which are on the critical path have an inherit risk in terms of the overall project schedule. Finding ways to reduce risks which may compress that schedule are vital, and the critical path shows which activities need more attention with regards to risk responses and risk prevention.
9. Procurements Management Knowing that a subcomponent that is contracted out is on the critical path will help you work with the procurements manager to design a contract that will give incentives and/or penalties to make sure the subcomponent is delivered on time.

So knowing the critical path and, by extension, what the non-critical paths of the project are, can be helpful in all knowledge areas related to project management. It isn’t called a critical path for nothing.

Time Management—Formulas relating to PERT analysis


In preparing for the PMP exam, it is of course a good idea to get a PMP exam prep text that has sample test questions at the end of each chapter covering one of the knowledge areas on the exam, but to really make sure you are ready for the exam, I strongly recommend getting text prep software that will allow you to test yourself on a larger bank of exam questions.

When reviewing the Time Management chapter, it seemed that questions involving the formulas involved with PERT analysis came up with high frequency on the practice mini-exams. The purpose of this post is to review these formulas and to give an example of the kind of question you would get on the examination that would involve them.

1. Introduction

Well, what is PERT? It is a variation on the three-point estimate, which can be used for estimating costs or time durations. A one-point estimate would be a “best guess” of what the time duration would be, let’s say. However, a more accurate estimate would be a three-point estimate, with one of the points being the most likely duration, then a pessimistic estimate of the duration, and an optimistic estimate of the duration.

Anybody who drives in LA is intuitively familiar with the concept, even if they are not a project manager, quality engineer, or have any interest in statistics whatsoever. If Mapquest tells you that to go from point A to point B it takes 30 minutes, then you assume that it is the most likely estimate. However, if there is a risk to your being late, let’s say, if it is an appointment with a client or a job interview, then you would probably do a more pessimistic estimate of, say, 45 minutes, to account for the risk of there being a traffic accident or something that will slow you down. And if you are fortunate to have a GPS system or even a smartphone that tells you about any traffic accidents that have occurred on your route, you have the possibility of reducing the risk by taking an alternate route. An optimistic estimate might be 25 minutes, if you just happen to hit all the green lights on the way to the freeway. So this concept of optimistic and pessimistic estimates is something people do all the time, but the PERT analysis formalizes it in the context of project management.

2. PERT formulas

The regular three-point estimate is simply the average of the pessimistic (P), most likely (M), and optimistic (O) estimates or

(P + M + O)/3

PERT analysis takes the weighted average, which gives 4 times as much weight to the most likely or M estimate. Here’s the formula for the PERT or weighted average:

Formula 1: Weighted average

(P+ 4M + O)/6

Here’s how to remember the six in the denominator: instead of the regular average, with the weighted average, it is like you are adding M four different times to the sum, but since you have now six terms to cover in the average, and hence you divide by six.

The standard deviation is the measure of the difference between the values in the distribution on either end and the value in the middle (the average). The bigger the standard deviation, the wider the spread of the values. The formula for the standard deviation for PERT analysis is

Formula 2: Standard deviation

(P – O)/6

NOTE: This is really an approximation of the standard deviation for the purpose of statistically challenged project managers. Any person with a Six Sigma background would take a look at this formula and laugh. However, in the spirit of professional harmony, a project manager can safely ignore any sound of derision coming from the quality department and use the formula safely in the knowledge that it’s what’s recommended by PMBOK.

The variance is just the standard deviation squared, or

Formula 3: Variance

[(P – O)/6]2

This is used if you trying to get the estimate for the whole project. What you do is get the total of the estimates for all activities A through Z along the critical path. Then you take the variance for each activity, sum them up across the whole project, and take the square root to get the standard deviation for the project estimate. However, for questions only involving one activity, you will only need formulas 1 and 2 for the weighted average and standard deviation, respectively.

There’s one more thing you need to know for PERT analysis question is the following three figures for the standard deviations:

±1σ = 68.27%

±2σ = 95.45%

±3σ = 99.73%

If you have a “normal” distribution, and you try to calculate those values which are plus or minus 1 sigma or standard deviation from the average (aka the mean), you can be assured that 68% of the values fall within that range. Now on the exam, it will say “95.45%” and you are expected to know that that is 2 standard deviations, similarly with “68.27%” for 1 standard deviation and “99.73%” for 3 standard deviations or 3 sigma.

NOTE: That is, by the way, the origin of the term “six sigma”, meaning three sigma or standard deviations above and below the mean, meaning you are striving for quality such that 99.73% of your production is without defect.

3. Sample question

Let’s take a three-point estimate example from the world of IT. If programming a certain module will take an average programmer 25 hours to do as the most likely estimate, the pessimistic estimate of 35 hours may be based on the assumption that a newbie is assigned to the task, whereas the optimistic estimate of 20 hours may be if they can get the veteran programmer Jones, who is rumored to dream in code. Using the weighted average technique, you determine that there is a 95.5% probability that the module will be completed in:

  1. Between 25.83 and 28.33 hours
  2. Between 23.33 and 28.33 hours
  3. Between 25.83 and 30.33 hours
  4. Between 20.83 and 30.33 hours

Step 1: What is the PERT weighted average?

Weighted average = (P + 4M + O)/6 = (20 + 4*25 + 35)/6 = 25.83 hours

Step 2: What is the standard deviation?

Standard deviation = (P – O)/6 = 2.5 hours

Step 3: What is the range?

This last step means that the upper end of the range equals the weighted average + (1, 2, or 3 standard deviations), and the lower end of the range equals the weighted average – (1, 2, or 3 standard deviations). How do you know how many standard deviations you add or subtract? You have to infer that from the 95.5% probability figure, which is a confidence level corresponding to 2 standard deviations away from the weighted average.

So the upper end of the range = weighted average + 2σ = 25.83 + 2*2.5 hours = 30.83 hours

And the lower end of the range = weighted average – 2σ = 25.83 – 2*2.5 hours = 20.83 hours

The answer therefore is D. The other answers are for people that assume that it is only one standard deviation and/or those who remember you have to get the range by adding AND subtracting from the weighted average.

In the next post, I will move onto the question of the critical path and how you can make it work for you as a project manager.

#PM Time Management—Review of Estimating Techniques


1. Introduction

In this series of posts, I am going into detailed issues regarding the time management area for project managers.  In particular, I am focusing on the following process, 6.4 Estimate Activity Durations, which I have highlighted in the chart below summarizing the processes as given in the PMBOK Guide.

Process Group Process Number Process  Name Process Description
Planning 6.1 Define Activities Identifying actions to be performed to produce product deliverables.



6.2 Sequence Activities Identifying and documenting relationships among the project activities.



6.3 Estimate Activity Resources Estimating type and quantities of resources (human and material) required to perform each activity.



6.4 Estimate Activity Durations Approximating the number of work periods needed to complete individual activities with estimated resources.



6.5 Develop Schedule Analyzing activity sequences, durations, resources requirements, and schedule constraints to create product schedule.



Monitoring & Controlling 6.6 Control Schedule Monitoring the status of the project to update project progress and manage changes to schedule baseline.

Here are the tools and techniques associated with this process.

6.4 Estimate Activity Durations Approximating the number of work periods needed to complete individual activities with estimated resources. 1. Expert judgment

2. Analogous estimating

3. Parametric estimating

4. Three-point estimates

5. Reserve analysis

1, 2, and 3 are top-down techniques

4 and 5 are bottom-up techniques

The purpose of this post is to briefly explain the general difference between these techniques.

2. Top-down and botton-up techniqes.

First of all, the five techniques can be divided into two broad categories, top-down and bottom-up techniques; the first three in the chart above are top-down techniques and the last two are bottom-up techniques. How are they different? Think of a WBS: the lowest level is represented by the work packages, which are connected upwards in the WBS to control accounts, and you keep going on up to the top of the WBS where you get the top box representing the entire project. A top-down estimate starts from the top of the WBS, i.e., an estimate for the entire project based on a previous project that is similar. So are top-down estimates impossible for a project which is totally new to a company? Not necessarily; they may new to the company, but they may be common in the industry, in which case you could use a top-down estimate for a project which another company has done.

Let’s go through these top-down techniques. Let’s use an example: you are bidding on a building a house for an existing subdivision. What is your estimate for building the house?

a. Expert judgment

Has someone in the company built a house in the subdivision before? Or is there somebody in the construction industry who has built a house in this subdivision before? For the purposes of this task, that person is an expert.

b. Analogous estimating

The purpose of asking an expert in technique a) is obtain an estimate for a similar project, which is called an analogous estimate. Assuming the size of the house you are bidding on is the same or similar to a house, you may be able to use this estimate for your own building project.

c. Parametric estimating

Let’s say that the new house is a different size than the others twice in the subdivision. One way to get the estimate would be to take a single variable related to the house, such as the number of square feet, and calculate the building cost of the other houses in the subdivision. Then you have an average cost per square foot, from which you can take the proposed building with its estimate of square feet and use that to calculate the building cost of the new house.

Top-down estimates are useful for rough estimates, but to get more accurate estimates, you need to go to bottom-up techniques. These are estimates based on the bottom of the WBS, i.e., work packages, especially those that have been further broken down in process 6.1 Define Activities and 6.2 Sequence Activities

d. Three-point estimates

The three points of the three-point estimate are the middle point or the most likely estimate (M), the pessimistic estimate (P), and the optimistic estimate (O). The alternative to the three-point estimate would be just to give the most likely estimate, but that does not supply the additional information about the accuracy of the estimate that is given by the three-point estimate.

A variation on the three-point estimate is the PERT analysis (PERT stands for “Program Evaluation and Review Technique”). This gives more confidence or weight to the most likely estimate in formulas that deal with the expected activity duration, activity standard deviation, and activity variance. The analysis part of PERT comes in taking the expected activity duration for each activity on the critical path and combining them to get the total expected duration of the project.

e. Reserve analysis

The three-point estimate is an excellent tool for doing reserve analysis for this reason. When asking people for their pessimistic and optimistic estimates for each activity, ask them for their assumptions on WHY they are making those estimates. For example: if programming a certain module will take a programmer 25 hours to do as the most likely estimate, the pessimistic estimate of 40 hours may be based on the assumption that a newbie is assigned to the task, whereas the optimistic estimate of 20 hours may be if they can get the veteran programmer Jones, who is rumored to dream in code.

These assumptions may uncover the risks or events which can positively or negatively affect the project. The reserve analysis is an output of the risk management knowledge area and takes the cost of implementing a risk response and adds it to the project estimate in the form of what is called a contingency reserve to get the cost baseline. In this example, one way to cut 5 hours out of the project activity duration would be to hire Jones, which would cost more since he (or she) is paid more per hour. That money used to take advantage of this opportunity (assuming Jones is available) would come out of the contingency reserve that was established as part of the reserve analysis, which in turn was done using the three-point estimate process as a starting point.

Out of the five techniques, the one that in my experience seems to be asked about the most in connection with formulas is the three-point estimate or PERT technique. This technique and the typical exam question covering it will be covered in the next post.

Time Management—Why Padding an Estimate Isn’t Professional


In time management, the project management processes involving the time management knowledge area are as follows:

Process Group Process Number Process
Name
Process Description
Planning 6.1 Define Activities Identifying actions to be performed to produce product deliverables.



6.2 Sequence Activities Identifying and documenting relationships among the project activities.



6.3 Estimate ActivityResources Estimating type and quantities of resources (human and material) required to perform each activity.



6.4 Estimate ActivityDurations Approximating the number of work periods needed to complete individual activities with estimated resources.



6.5 Develop Schedule Analyzing activity sequences, durations, resources requirements, and schedule constraints to create product schedule.



Monitoring & Controlling 6.6 Control Schedule Monitoring the status of the project to update project progress and manage changes to schedule baseline.

When it comes to process 6.4 Estimate Activity Durations, which is the process you need to finalize the schedule in the next process, one practice project managers use to make sure that they give enough time to complete all the activities is padding, or adding an arbitrary amount to each estimate.

Why is this practice not considered professional? Here are some reasons on why padding would have a potential negative impact on other knowledge areas of project management.

Project Management Area What effect does padding have?
1. Integration Management Is it a waste of resources—essentially a “fat” process instead of a lean one. This means that resources are tied up in your project that could legitimately be assigned to other projects. In may give you some padding, but at the expense of other viable projects, so it is bad from a program manager’s standpoint.
2. Scope Management If there is a scope change, the effect on the time and cost constraints will be harder to gauge because the estimates are not realistic.
3. Time Management The time estimate is not realistic and so the calculations of the schedule variance or schedule performance index will not be accurate. This will increase the chance of the project not being completed in a timely manner.
4. Cost Management The time estimate not being realistic also means that the cost estimate is not realistic either. For similar reasons to those in the time management paragraph above, the chance of the project not being completed within budget will increase, because the inaccuracy of the cost variance or cost performance index.
5. Quality Management Activity estimates related to quality are unrealistic, making the cost of quality unrealistic. Any question from management about the cost of quality vs. cost of nonconformance is going to have an added level of uncertainty, leading to potential bad effects on product quality.
6. HR Management With less buy-in by the team members of the schedule and/or budget because of their being unrealistic, it also means that there will be less team building and more possibility for conflict.
7. Communications Management Reduces the reliability of the estimate, and therefore you have less buy-in from team members. Also, encourages padding from team members as well on the estimates of their own work.
8. Risk Management Makes it harder to identify risks or bottlenecks in the sequence of activities. Since risks are more hidden, the risk reserves are not accurate, and this compounds the inaccuracy of the overall budget.
9. Procurements Management Estimates of work packages to be contracted out are unrealistic, making it harder to work with suppliers to deliver their components in a timely manner that meets the contractual cost targets.

So, with all of these potentially bad effects on ALL knowledge areas relating to project management, can you see why padding, rather than decreasing risk, actually ends up inflating it?

The next post will deal with the usefulness of the network diagramming method and the critical path? How does the critical path help the project manager?

Time Management Knowledge Area—Define Activities Process: A Closer Look


In my previous posts relating to the processes, I laid out the inputs, tools & techniques and outputs for all the 42 project management processes listed in the PMBOK® Guide in a general way.  I would like to go into more detail about all of these elements for the process 6.1 Define Activities in this post.

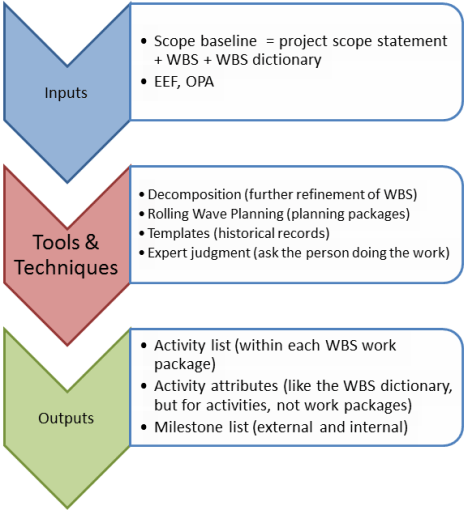

Fig. 1 Inputs, tools & techniques, and outputs of process 6.1 DEFINE ACTIVITIES

The inputs to the process 6.1 Define Activities are:

Input Explanation
1. Scope Baseline Remember that the “scope baseline” is shorthand for three separate things: the project scope statement, the WBS, and the WBS dictionary. These are outputs of the process 5.3 Create WBS.
2. Enterprise Environmental Factors The project management information system (Microsoft Project or whatever the organization chooses to use) is the software which which help manage the breakdown of work packages into activities, and the inclusion of milestones.
3. Organizational Process Assets These are policies and guidelines of the company with regards to the scheduling process.

The techniques of the process 6.1 Define Activities are

Technique Explanation
1. Decomposition This is the same technique used to create the WBS, but now carried down to the level of activities. The WBS goes down to the smallest level of deliverables possible, called a work package; the decomposition technique under the 6.1 Define Activities takes the process further down from work package
deliverables, and lists which activities need to be done to complete the work packages.
2. Rolling Wave Planning This is form of progressive elaboration. The near term deliverables are broken down into work packages, which then are further broken into activities in this process. The deliverables later on in the project are summarized in planning packages, which are then broken down as you get closer to that part of the project. It’s like laying down the tracks ahead of you while the train is moving.
3. Templates Why reinvent the wheel? If the project you are doing has similarities to other projects done in the past, use these as guides for creating activities lists for the work packages.
4. Expert judgment If you want to know how to get something done, ask the person who does it? In this sense, expert does not necessarily mean an SME, but someone who is expert at doing the work involved in the work package.

The outputs to the process are

Output Explanation
1. Activity List The list of activities should include enough detail for those doing the work to understand what they need to do.
2. Activity Attributes The WBS dictionary is a list of attributes of the work packages such as who is responsible, what resources are to be used to produce the deliverable, etc. The activity attributes are to the activities what the WBS dictionary is to the work packages, a list of attributes which gives details about the activities to be done. The activities themselves should be clear enough for the person doing them; the activity attributes are intended to be information for the project management team to help manage the work.
3. Milestone list There are two types of milestones: those imposed by the customer (by contract or otherwise) for external projects, and by the sponsor for internal projects. In addition to these external milestones, i.e., those imposed by those outside the project team, there are internal milestones that the project manager sets to aid him or her in the management of the project.

Thus the external milestones by the customer are geared more towards the needs of the customer, either in terms of reporting interim results or perhaps signalling the inspection of interim deliverables through the process 5.4 Verify Scope.

The internal milestones set by the project manager are geared towards the needs of monitoring and controlling the project schedule (process 6.6 Control Schedule) and/or project cost (process 7.3 Control Costs), or for reporting results to management (process 10.5 Report Performance).

The milestone list is added to the scope baseline and internal milestones may be added as part of Control Accounts, those portions of the WBS above the work package level, where the results of the work packages in the level below the Control Account are “added up” and analyzed.

Once the activities are listed as an output to process 6.1, they become the input to the next Time Knowledge Area process, 6.2 Sequence Activities, which involves the use of Network Diagrams. This will be the subject of the next post.
